malaysiakini logo
story-image
story-image
mk-logo
News
Yeo: Nation’s first geothermal power project found abandoned
ADS

PARLIAMENT | The country’s first geothermal power plant project in Sabah, which should have been operational by Dec 31, 2017, has been found abandoned and overgrown with weeds, the Dewan Rakyat was told today.

Energy, Science, Technology, Environment and Climate Change Minister Yeo Bee Yin said the project, which was implemented on July 2, 2015, was not showing any progress.

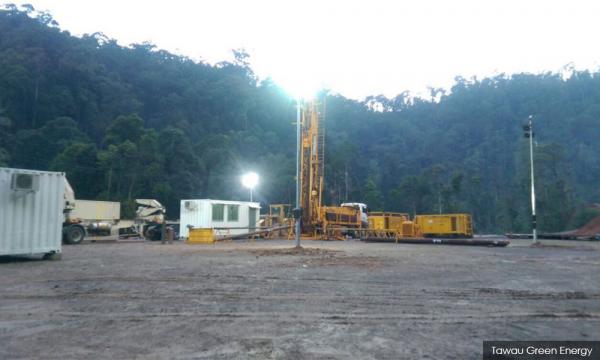

“For example, drilling stopped in the third quarter of 2016 and the slim holes had been closed … all cabins and drilling equipment are no longer at the site, no workers were found there and the area is covered with overgrowth,” she said during the minister's question time.

Yeo was replying to the original question by Chan Foong Hin (PH-Kota Kinabalu), who wanted the government to state the status on the construction of the power plant in Apas Kiri, Tawau.

 The project, which was developed by Tawau Green Energy Sdn Bhd, appeared to have stopped operations and therefore on Aug 29, 2018, the government, through the Sustainable Energy Development Authority (Seda), decided to cancel the approval given.

Yeo said the 37-megawatt generation incentive quota from the project would be redistributed to other viable renewable energy projects especially biogas, biomass and hydro.

On a supplementary question by Chan on whether the government would ensure the project is saved as RM35 million from Private Public Partnership Unit had been spent, Yeo said at the moment, there are plans for the project.

“This is because geothermal projects sometimes cost more than new energy sources but we will study the technology and suitability of the project from time to time.

“When it makes business sense, we will continue with implementation. Nonetheless, we will offer the project again through open tender,” she said.

Bernama


Please join the Malaysiakini WhatsApp Channel to get the latest news and views that matter.

View Comments
